A document with writing on it

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

Revision History

Rev.

Description of Modification

Date

0.

First issue for comments

24/9/2025

1.

Response to IEC’s comments

2/10/2025

2.

Response to IEC’s comments

20/10/2025

3.

Response to IEC’s comments

21/10/2025

Table of Content

EXECUTIVE SUMMARY.. 1

1      INTRODUCTION.. 4

1.1      Project Background.. 4

1.2      Purpose of the Report. 5

1.3      Report Structure. 5

2      AIR QUALITY.. 8

2.1      Monitoring Requirement. 8

2.2      Monitoring Parameters, Frequency and Duration.. 8

2.3      Monitoring Location.. 8

2.4      Monitoring Equipment and Methodology.. 9

2.5      Results and Observations. 9

2.6      Action and Limit Levels. 15

3      Construction Noise. 16

3.1      Monitoring Requirement. 16

3.2      Monitoring Parameters, Frequency and Duration.. 16

3.3      Monitoring Location.. 16

3.4      Monitoring Equipment. 20

3.5      Monitoring Methodology.. 20

3.6      Maintenance and Calibration.. 21

3.7      Results and Observations. 21

3.8      Action and Limit Level. 23

4      WATER QUALITY.. 24

4.1      Monitoring Requirements. 24

4.2      Water Quality Parameters and Monitoring Frequency.. 24

4.3      Monitoring Locations. 24

4.4      Monitoring Equipment and Methodology.. 27

4.5      Laboratory Measurement and Analysis. 28

4.6      QA/QC Requirements. 29

4.7      Results and Observations. 29

4.8      Action and Limit Levels. 31

5      COMMENTS AND CONCLUSION.. 34

5.1      Revision for Inclusion in the EM&A Manual. 34

5.2      Air Quality.. 34

5.3      Construction Noise. 34

5.4      Water Quality.. 34

5.5      Comment/ Recommendation.. 35

List of Tables

Table 2.1

Baseline Air Quality Monitoring Parameters, Frequency and Duration

Table 2.2

Air Quality Monitoring Stations for Baseline and Impact Monitoring of Non-Schedule 2 DP under HSK/HT NDA Stage 1 Works

Table 2.3

Photo of Baseline Air Quality Monitoring Stations (AM18, AM19 and AM20)

Table 2.4

Baseline Air Quality Monitoring Equipment

Table 2.5

Summary of Baseline 1-hour TSP Monitoring Results

Table 2.6

Determination of Action and Limit Levels for Air Quality Monitoring during Construction Period

Table 2.7

Action and Limit Levels of Impact Monitoring of 1-hour TSP

Table 3.1

Baseline Construction Noise Monitoring Parameters, Frequency and Duration

Table 3.2

Noise Monitoring Stations for Baseline and Impact Monitoring

Table 3.3

Summary of Noise Monitoring Results during 07:00 – 19:00

Table 3.4

Summary of Noise Monitoring Results during 19:00 – 23:00

Table 3.5

Summary of Noise Monitoring Results during 23:00 – 07:00 of the following day

Table 3.6

Action and Limit Levels for Construction Noise Monitoring

Table 4.1

Parameters measured in the Baseline Water Quality Monitoring

Table 4.2

Water Quality Monitoring Stations for Non-Schedule 2 DP under HSK/ HT NDA Stage 1 Works

Table 4.3

Detection Limits and Precision for Water Quality Determinates

Table 4.4

Analytical Methods Applied to Water Quality Samples

Table 4.5

Summary of Baseline Water Quality Monitoring Results of U1, SW, HT, TKW and TKW1 (Wet Season)

Table 4.6

Summary of Baseline Water Quality Monitoring Results of U1, SW, HT, TKW and TKW1 (Dry Season)

Table 4.7

Summary of Baseline Water Quality Monitoring Results at TSR1a, LUTa, LFS, D1 and D2a

Table 4.8

Determination of Action and Limit Levels of Water Quality for Impact Monitoring

Table 4.9

Action and Limit Levels for Water Quality at SW, HT, TKW1 and TKW (Wet Season)

Table 4.10

Action and Limit Levels for Water Quality at SW, HT, TKW1 and TKW (Dry Season)

Table 4.11

Action and Limit Levels for Impact Water Quality Monitoring at D2a and D1

List of Figures

Figure 1.1

Project Layout Plan

Figure 2.1

Air Quality Monitoring Locations for Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Figure 2.2

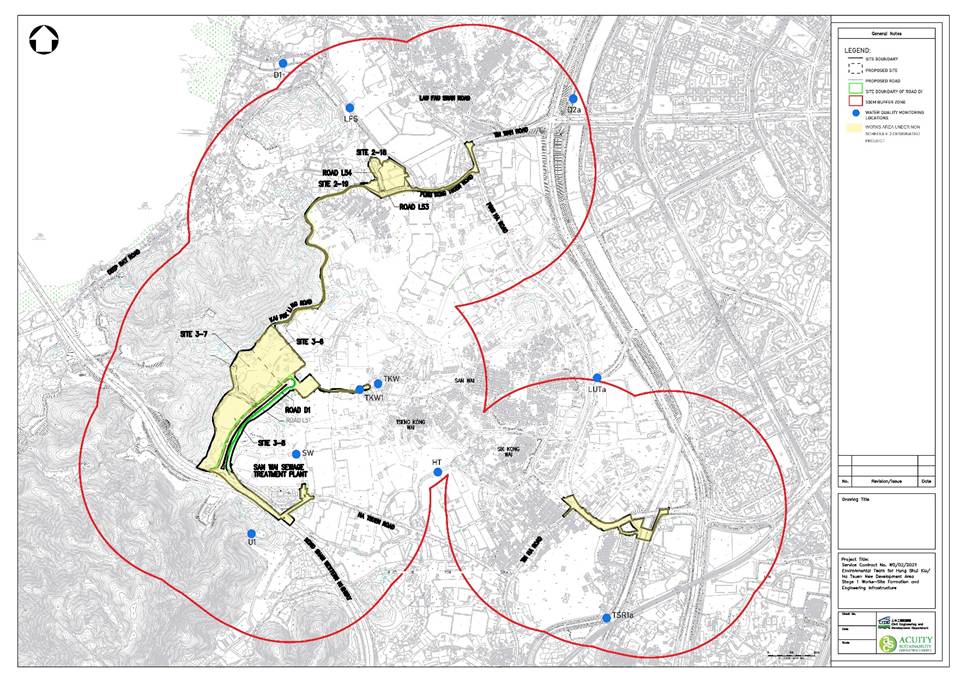

Air Quality Monitoring Locations for Non-Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Figure 3.1

Construction Noise Monitoring Locations for Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Figure 3.2

Construction Noise Monitoring Locations for Non-Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Figure 4.1

Locations of Water Quality Monitoring Stations for Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Figure 4.2

Locations of Water Quality Monitoring Stations for Non-Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

List of Appendices

Appendix A

Air Quality Monitoring Equipment Calibration Certificates

Appendix B

Baseline Air Quality Monitoring Results and Graphical Presentation

Appendix C

Event and Action Plan

Appendix D

Extract of Meteorological Observations for Hong Kong – Lau Fau Shan

EXECUTIVE SUMMARY

Baseline monitoring for air quality, noise and water quality for non-Schedule 2 Designated Project (DP) under Hung Shui Kiu/Ha Tsuen New Development Area (HSK/HT NDA) Stage 1 Works were conducted.

A total of 14 air quality monitoring stations was identified for the EM&A programme of non-Schedule 2 DP.  Baseline air quality monitoring at AM18, AM19 and AM20 was conducted from 6 August 2025 to 19 August 2025.  Baseline air quality monitoring of the other 11 stations (including AM7, AM8a, AM9, AM11, AM12, AM13 AM15, AM21, AM23, AM24 and AM25a) had been carried out before and the monitoring results had been verified.  The Action and Limit Levels derived from the Updated EM&A Manual are presented in Table A1.

Table A1     Action and Limit Levels of Impact Monitoring of 1-hour Total Suspended Particulates

Monitoring Station(s)

Action Level (µg/m3)

Limit Level (µg/m3)

Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road

AM18

285

500

AM19

282

AM20

268

AM21

275

Road L51

AM23

290

500

AM24

290

AM25a

300

Sha Chau Lei Tsuen

AM7

282

500

AM8a

267

AM9

276

AM11

276

AM12

273

AM13

264

AM15

271

A total of 5 noise monitoring stations was identified for the EM&A programme of non-Schedule 2 DP.  Baseline noise monitoring at CM6 had been carried out before and the monitoring results had been verified by the IEC of the project of Road Widening Works at Tin Wah Road.  Baseline noise monitoring at CM20, CM22, CM26 and CM30 had also been carried out before and the monitoring results had been verified by the IEC of HSK/HT NDA Second Phase Development.  The Action and Limit Levels to be adopted are presented in Table A2.

Table A2     Action and Limit Levels for Construction Noise Monitoring

Time Period

Action

Limit

07:00 - 19:00 on normal weekdays

When one or more documented complaints are received

75 dB(A)

A total of 10 water quality monitoring stations was identified for the EM&A programme of non-Schedule 2 DP.  Baseline water quality monitoring at U1, SW, HT, TKW and TKW1 had been carried out and the monitoring results had been verified by the IEC of HSK/HT NDA Stage 1 Works.  Baseline water quality monitoring at TSR1a, LUTa, LFS, D1 and D2a had been carried out and the monitoring results had been verified by the IEC of HSK/HT NDA Second Phase Development. The Action and Limit Levels derived from the Updated EM&A Manual are presented in Tables A3 to A5.

Table A3     Action and Limit Levels for Water Quality at SW, HT, TKW1 and TKW (Wet Season)

Parameters

Action Levels

Limit Levels

SW

DO (mg/L)

3.7

3.5

Turbidity (NTU)

21.4

22.9

SS (mg/L)

9.7

9.9

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

HT

DO (mg/L)

2.4

2.2

Turbidity (NTU)

32.3

32.6

SS (mg/L)

34.0

38.7

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

TKW1

DO (mg/L)

2.8

2.8

Turbidity (NTU)

27.9

29.2

SS (mg/L)

16.0

18.4

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

TKW

DO (mg/L)

2.5

2.4

Turbidity (NTU)

24.2

24.6

SS (mg/L)

19.8

21.6

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

Table A4     Action and Limit Levels for Water Quality at SW, HT, TKW1 and TKW (Dry Season)

Parameters

Action Levels

Limit Levels

SW

DO (mg/L)

2.3

2.1

Turbidity (NTU)

22.0

22.3

SS (mg/L)

8.8

10.5

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

HT

DO (mg/L)

2.2

2.1

Turbidity (NTU)

18.2

20.1

SS (mg/L)

7.2

7.5

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

TKW1

DO (mg/L)

2.1

2.0

Turbidity (NTU)

16.4

17.6

SS (mg/L)

7.1

7.8

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

TKW

DO (mg/L)

2.2

2.2

Turbidity (NTU)

26.0

26.7

SS (mg/L)

7.0

7.1

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

Table A5     Action and Limit Levels for Impact Water Quality Monitoring at D2a and D1

Parameters

Action Levels

Limit Levels

D2a

DO (mg/L)

5.4

4

Turbidity (NTU)

11.6

11.7

SS (mg/L)

14.0

15.6

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

D1

DO (mg/L)

4.2

4

Turbidity (NTU)

23.4

24.5

SS (mg/L)

32.8

36.8

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

1                INTRODUCTION 1.1           Project Background 1.1.1        The HSK/HT NDA occupies an area of approximately 714 ha and is located in the north-western part of the New Territories, midway between Tuen Mun and Tin Shui Wai New Towns.  It is bounded by Tin Ying Road/ Ping Ha Road/ Kiu Hung Road to the east, Castle Peak Road to the south, Kong Sham Western Highway (“KSWH”) to the west, and Tin Ha Road, Lau Fau Shan Road and hillslopes along Deep Bay Road to the north.  In the wider context, the proposed Project is strategically located in close proximity to Shenzhen, particularly Shenzhen Bay Control Point, Qianhai, and Shekou and efficiently linked with the Greater Pearl River Delta (“PRD”) region.  The KSWH and the possible highway connecting the Project area with the Tuen Mun - Chek Lap Kok Link, the Hong Kong International Airport, Kwai Tsing Container Terminals, and the Hong Kong-Zhuhai-Macao Bridge and its Boundary Crossing facilities.  New strategic highway infrastructure connecting the Project area with the urban area will also be planned to address the long-term development needs of North West New Territories (“NWNT”).  The proposed West Rail Hung Shui Kiu Station (“HSK Station”), with its alignment traversing the Project allows convenient and efficient access to and from the Project area. 1.1.2        The works under HSK/HT NDA Stage 1 Works comprises: Schedule 2 Designated Project •        The construction of interim section of new distributor road (Road D1) connecting Sites 3-6, 3-7 and 3-8 to the existing Ha Tsuen Roundabout of KSWH.  Road D1 a designated project (“DP”) defined under item A1 in Schedule 2 of the Environmental Impact Assessment Ordinance) and it is governed under Environmental Permit No. EP-528/2017. Non-Schedule 2 Designated Project: •        Infrastructure works at Road L51; •        Site formation and infrastructure works at Site 2-18 and 2-19; •        Sewer laying works along Fung Kong Tsuen Road and Ping Ha Road/ Lau Fau Shan Road; and •        Pipe jacking work near Sha Chau Lei Tsuen. 1.1.3        The layout plan for HSK/HT NDA Stage 1 Works is shown in Figure 1.1.   1.1.4        The HSK/HT NDA Stage 1 Works would be implemented under a fast-track programme, involving various complex tasks for providing infrastructure and forming the five development sites to be conducted in parallel, so as to tie in with operation of the development MSBs or other land-efficient means and population intake of the village resite house in 2025 tentatively. 1.1.5        Acuity Sustainability Consulting Limited (ASCL) is commissioned by Civil Engineering and Development Department (CEDD) to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment (EIA) Report (Register No. AEIAR-203/2016) and Environmental Monitoring and Audit (EM&A) Manual for the Project; and to carry out the EM&A programme in fulfillment of the EIA Report’s, EM&A requirements under Service Contract No. WD/02/2021. 1.1.6        Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection Department (DEP) granted the Environmental Permits (Nos.: EP-526/2017, EP-527/2017, EP-528/2017, EP-529/2017, EP-530/2017 and EP-531/2017) to the CEDD for the HSK/HT NDA.  The HSK/HT NDA Stage 1 Works comprise the interim section of Road D1 that is governed under Environmental Permit No. EP-528/2017.  No other Schedule 2 DPs are identified within the scope of HSK/HT NDA Stage 1 Works. 1.2           Purpose of the Report 1.2.1        The EM&A requirements for baseline monitoring under Contract No. YL/2020/03 are set out in the Updated EM&A Manual (April 2022) and Contract Specification.  Environmental aspects of air quality, construction noise and water quality were identified as the key issues requiring implementation of monitoring programme during the construction phase of the Project.  A Baseline Monitoring Report for Schedule 2 DP (i.e. the interim section of Road D1) had been prepared and submitted in August 2023([1]) under Condition 3.3 of EP-528/2017. 1.2.2        For the concerned areas with ongoing or future construction work for non-Schedule 2 DP under HSK/HT Stage 1 Works, this report presents the baseline air quality, noise and water quality monitoring results at the monitoring stations that are within the buffer distances (500 m for air quality and water quality, and 300 m for noise) from the site boundaries.  Action and Limit Levels are also defined for impact monitoring. 1.3           Report Structure 1.3.1        This Baseline Monitoring Report comprises the following sections:

Section 1     introduces the background of the Project and purpose of this Report;

Section 2     presents the baseline monitoring methodologies, requirements, results, influencing factors, as well as determination of the action and limit levels of air quality;

Section 3     presents the action and limit levels of construction noise;

Section 4     presents action and limit levels of water quality; and

Section 5     concludes the findings of baseline monitoring.

Figure 1.1        Project Layout Plan
2                AIR QUALITY 2.1           Monitoring Requirement 2.1.1        Baseline air quality monitoring shall be carried out to determine the ambient 1-hour Total Suspended Particulates (TSP) levels at designated monitoring stations for 14 consecutive days prior to the commissioning of the construction works.  1-hour TSP monitoring should be carried out at least three times per day at each monitoring station when the highest dust impact is expected. 2.2           Monitoring Parameters, Frequency and Duration 2.2.1        Table 2.1 summarizes the monitoring parameters, frequency and duration of baseline air quality monitoring.

Table 2.1     Baseline Air Quality Monitoring Parameters, Frequency and Duration

Parameters

Duration

Frequency

1-hour TSP

Daily for at least 14 consecutive days

3 times per day

2.3           Monitoring Location 2.3.1        According to the Updated EM&A Manual([2]), the designated locations for air quality monitoring of non-schedule 2 DP are listed in Table 2.2.

Table 2.2     Air Quality Monitoring Stations for Baseline and Impact Monitoring of Non-Schedule 2 DP under HSK/HT NDA Stage 1 Works

Station(s)

EIA ID

Monitoring Location

Approximate Distance between the Stations and the Nearest Site Boundaries

Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road

AM18

A1303

Sha Kong Wai Tsai

77 m

AM19

A1305

Ngau Hom Tsuen

389 m

AM20

A1302

Wing Jan School

352 m

AM21†

A1002

Fung Kong Tsuen

86 m

Road L51*

AM23

P1032

Planned Port Back-up, Storage and Workshop (at Site 3-6)

176 m

AM24

P1501

Planned Port Back-up, Storage and Workshop (at Site 3-8)

288 m

AM25a

-

San Wai Sewage Treatment Plant near the Planned Port Back-up, Storage and Workshop (at Site 3-14)

304 m

Sha Chau Lei Tsuen †

AM7

A414

Shek Po Tsuen

487 m

AM8a ‡

A813

Block J, Tin Shing Court

221 m

AM9

A702

San Uk Tsuen

349 m

AM11

A703

Sha Chau Lei Tsuen

28 m

AM12

A704

Ha Tsuen Shi

245 m

AM13

A708

Sik Kong Wai

351 m

AM15

A1101

Lo Uk Tsuen

480 m

Notes: *     Baseline air quality monitoring at AM23, AM24 and AM25a had been conducted under HSK/HT NDA Stage 1 Works in December 2021.  No further baseline monitoring at these stations was conducted. †     Baseline air quality monitoring at AM7, AM8a, AM9, AM11, AM12, AM13, AM15 and AM21 had been conducted under HSK/HT NDA Second Phase Development. No further baseline monitoring at these stations was conducted. ‡     The correct name of the monitoring location had been updated as proposed in the Proposal for Alternative Monitoring Locations (Air Quality, Construction Noise & Water Quality) with agreement from the IEC of HSK/HT NDA Second Phase Development, and the monitoring station ID had been revised from AM8 to AM8a under HSK/HT NDA Second Phase Development. 2.3.2        The locations of all designated air quality monitoring stations for Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works are shown in Figure 2.1. The locations of all designated air quality monitoring stations for non-Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works are shown in Figure 2.2.  Besides AM18, AM19 and AM20, baseline monitoring stations had been carried out at the other designated locations. Photos of air quality monitoring stations of AM18, AM19 and AM20 are presented in Table 2.3.

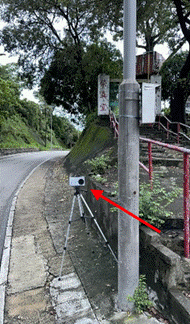

Table 2.3     Photos of Air Quality Monitoring Stations (AM18, AM19 and AM20)

ID

Direct Reading Dust Meter Position

 Monitoring Direction

AM18

AM19

AM20

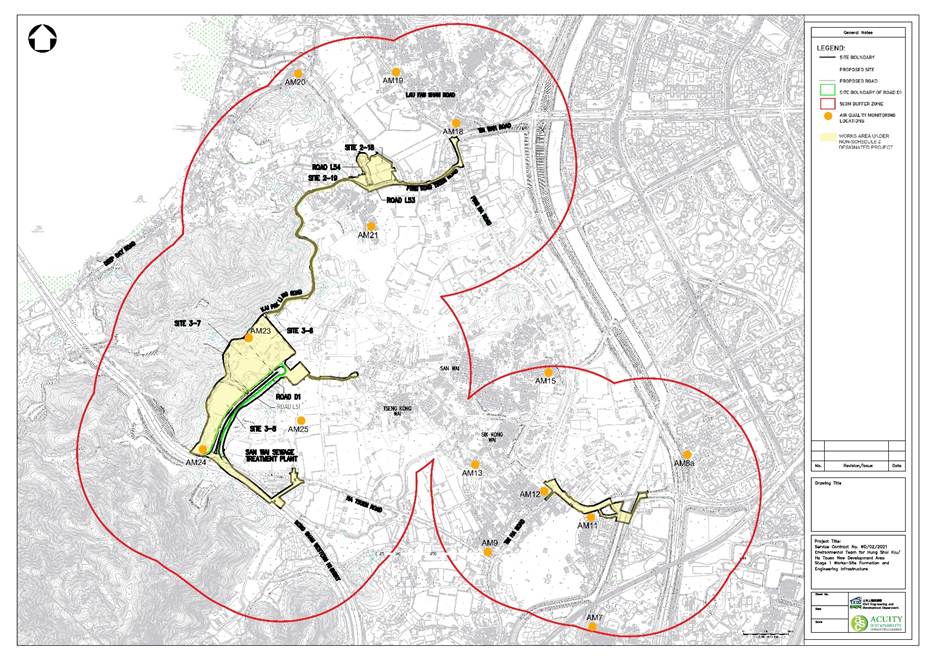

Figure 2.1 Air Quality Monitoring Locations for Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Figure 2.2 Air Quality Monitoring Locations for Non-Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

2.4           Monitoring Equipment and Methodology 2.4.1        Direct reading dust meters were used for measuring 1-hour TSP levels during the baseline air quality monitoring.  According to paragraph 4.3.5 of the Updated EM&A Manual([3]), the proposed use of direct reading dust meter was submitted to and agreed by the IEC of HSK/HT NDA Stage 1 Works. 2.4.2        The direct reading dust meters have been calibrated against high volume samplers (HVSs) annually.  A 2-day, three 3-hour measurement results per day from direct reading dust meters were taken to compare with the sampling results from the HVSs. The correlation between the direct reading dust meters and the HVSs were then concluded. By accounting for the correlation factor, the direct reading dust meters are considered to achieve comparable results as that of the HVSs. 2.4.3        Sufficient number of monitoring instruments were prepared by the ET for carrying out the baseline monitoring.  All equipment and associated instrumentation were clearly labelled. 2.4.4        Equipment used in the baseline air quality monitoring for AM18, AM19 and AM20 is summarized in Table 2.4.  Calibration certificates for the air quality monitoring equipment used in the baseline air quality monitoring for AM18, AM19 and AM20 are presented in Appendix A.

Table 2.4     Baseline Air Quality Monitoring Equipment

Equipment

Brand and Model

Serial No.

Direct Reading Dust Meter

Sibata LD-5R

851816

851820

992821

0Z4545

2.5           Results and Observations 2.5.1        The baseline air quality monitoring at AM18, AM19 and AM20 was carried out between 6 and 19 August 2025 (Figure 2.2).  The monitoring results are presented in Appendix B.  Weather condition of the whole baseline monitoring period was sunny, fine, cloudy and rainy.  Extracts of Meteorological Observations for Hong Kong available from the Hong Kong Observatory – Lau Fau Shan, which reflect the weather summary of the baseline air quality monitoring period, are presented in Appendix D. 2.5.2        Table 2.5 summarizes the baseline air quality monitoring results of AM18, AM19 and AM20.  The IEC of HSK/HT NDA Second Phase Development verified the baseline monitoring results of AM7, AM8a, AM9, AM11, AM12, AM13, AM15, AM21, AM23, AM24 and AM25a are also presented in Table 2.5.

A close-up of a calendar

AI-generated content may be incorrect.

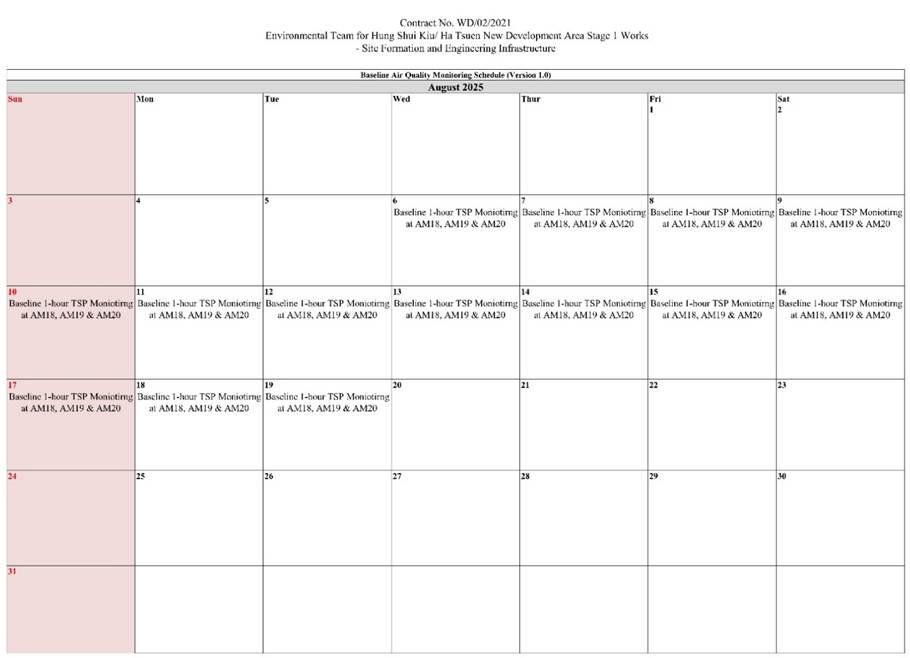

Figure 2.2 Baseline Air Quality Monitoring Schedule (AM18, AM19 and AM20)

Table 2.5     Summary of Baseline 1-hour TSP Monitoring Results

 Monitoring Stations

TSP Concentration, μg/m3

Average

Minimum

Maximum

Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road

AM18

54

28

88

AM19

49

23

78

AM20

28

11

45

AM21*

38

24

56

Road L51

AM23†

62

51

71

AM24†

62

51

70

AM25a†

77

62

98

Sha Chau Lei Tsuen

AM7*

49

34

67

AM8a*

26

13

54

AM9*

39

20

61

AM11*

39

22

60

AM12*

35

18

58

AM13*

21

11

42

AM15*

32

16

50

References: *     Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024. (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176) †     Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Baseline Monitoring Report (Environmental Permit No. EP-528/2017)”, August 2023.   2.5.3        During the baseline monitoring between 6 and 19 August 2025, construction works were ongoing at Site 2-18 and Site 2-19.  Fugitive dust suppression measures such as water spraying and covering open stockpiles were adopted on site during the monitoring period. With these air quality mitigation measures and the rainy weather during the baseline monitoring period, there are no signs of direct impact of the construction activities from Site 2-18 and Site 2-19 on the baseline air quality monitoring data.  Another dust emission source was the road widening works at Tin Wah Road near AM18, though the impact appears minimal due to dust suppression measures implemented on site and the wet weather during the monitoring period.  No other dust emission source was detected near AM19 and AM20.   2.5.4        The photo records of the adoption of air quality mitigation measures at Site 2-18 and Site 2-19 during the baseline monitoring period are presented in Plate 2.1 to Plate 2.12 respectively.

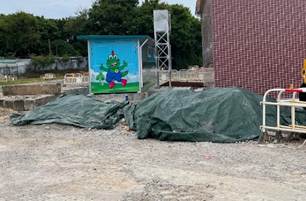

Plate 2.1 Air Quality Mitigation Measures Recorded on site on 6 August 2025

Plate 2.2 Air Quality Mitigation Measures Recorded on site on 7 August 2025

A person in a yellow hat standing on a road

AI-generated content may be incorrect.

Plate 2.3 Air Quality Mitigation Measures Recorded on site on 8 August 2025

Plate 2.4 Air Quality Mitigation Measures Recorded on site on 9 August 2025

Plate 2.5 Air Quality Mitigation Measures Recorded on site on 11 August 2025

A person in a yellow helmet holding a hose

AI-generated content may be incorrect.

Plate 2.6 Air Quality Mitigation Measures Recorded on site on 12 August 2025

A person wearing a yellow vest and a hat spraying water

AI-generated content may be incorrect.

Plate 2.7 Air Quality Mitigation Measures Recorded on site on 13 August 2025

A person wearing a yellow hat and standing on a road

AI-generated content may be incorrect.

Plate 2.8 Air Quality Mitigation Measures Recorded on site on 14 August 2025

A person standing in front of a construction site

AI-generated content may be incorrect.

Plate 2.9 Air Quality Mitigation Measures Recorded on site on 15 August 2025

 A building with a tarp and a tractor

AI-generated content may be incorrect.

Plate 2.10 Air Quality Mitigation Measures Recorded on site on 16 August 2025

Plate 2.11 Air Quality Mitigation Measures Recorded on site on 18 August 2025

A person spraying water on the road

AI-generated content may be incorrect.

Plate 2.12 Air Quality Mitigation Measures Recorded on site on 19 August 2025

A person wearing a yellow hat and holding a hose

AI-generated content may be incorrect.

2.6           Action and Limit Levels 2.6.1        The baseline 1-hour TSP monitoring results form the basis for determining the air quality criteria for the impact monitoring.  Table 2.6 shows the criteria for establishing the Action and Limit Levels for air quality monitoring.

Table 2.6     Determination of Action and Limit Levels for Air Quality Monitoring during Construction Period

Parameters

Action Level (µg/m3)

Limit Level (µg/m3)

1-hour TSP Level

(µg/m3)

BL ≤ 384 µg/m3, AL = (BL × 1.3 + LL)/2

BL > 384 µg/m3, AL = LL

500

2.6.2        Following the above guidelines, the Action and Limit Levels for 1-hour TSP impact monitoring of AM18, AM19 and AM20 were set.  They are presented in Table 2.7, together with the Action and Limit Levels of the other stations already defined.

Table 2.7     Action and Limit Levels of Impact Monitoring of 1-hour TSP

Monitoring Station(s)

Action Level (µg/m3)

Limit Level (µg/m3)

Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road

AM18

285

500

AM19

282

AM20

268

AM21 *

275

Road L51

AM23 †

290

500

AM24 †

290

AM25a †

300

Sha Chau Lei Tsuen

AM7 *

282

500

AM8a *

267

AM9 *

276

AM11 *

276

AM12 *

273

AM13 *

264

AM15 *

271

References: *   Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024. (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176)

†   Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Baseline Monitoring Report (Environmental Permit No. EP-528/2017)”, August 2023.

3                Construction Noise 3.1           Monitoring Requirement 3.1.1        Baseline construction noise monitoring shall be carried out at designated monitoring stations for 14 consecutive days.  The minimum logging interval shall be 30 minutes with average of 6 consecutive A-weighted equivalent continuous sound pressure level over 5 minutes (Leq(5-min)); L10 and L90 shall also be measured at 5-minute intervals. 3.2           Monitoring Parameters, Frequency and Duration 3.2.1        Table 3.1 summarizes the monitoring parameters, frequency and duration of the baseline air quality monitoring.

Table 3.1     Baseline Construction Noise Monitoring Parameters, Frequency and Duration

Parameter

Frequency and Duration

Leq (30mins) (as an average of 6 consecutive Leq (5-min)); L10 (5-min) and L90 (5-min)

Continuous for 14 consecutive days with each sampling period of 5 minutes throughout the monitoring

3.3           Monitoring Location 3.3.1        No designated noise monitoring stations are located within 300 m buffer distance from the site boundary of the Schedule 2 DP under HSK/HT NDA Stage 1 Work. Figure 3.1 presents that no monitoring had been conducted for the Schedule 2 DP under HSK/HT NDA Stage 1 Works. 3.3.2        According to the Updated EM&A Manual([4]), the designated noise monitoring stations that are within 300 m buffer distance from the site boundary of non-Schedule 2 DP under HSK/HT NDA Stage 1 Works are listed in Table 3.2.  Their locations are shown in Figure 3.2.

Table 3.2     Noise Monitoring Stations for Baseline and Impact Monitoring

ID No.

EIA ID

Location

Nature of Use

Type of Measurement

Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road

CM6 (a)

ELFS03

No. 325 Sha Kong Wai

Residential

Façade

CM26 (b)

EFKT01

No. 61, Fung Kong Tsuen

Residential

Free-Field

CM30 (b)

21801

Planned Residential Development in Site 2-18

Residential

Free-Field

Road L51

-

-

-

-

-

Sha Chau Lei Tsuen

CM20 (b)

ESCL03

No. 45, Sha Chau Lei Tsuen

Residential

Free-Field

CM22 (b)

ELUT01

Block 11, Yan Wu Garden

Residential

Free-Field

Note:

(a)    Baseline noise monitoring carried out under the CEDD’s Road Widening Works of Tin Wah Road (Quotation No. PU 01/2024) in accordance with EP-528/2017 was referred.

(b)    For Free Field measurement, +3 dB(A) should be added to the measured results.

A map of a city

AI-generated content may be incorrect.

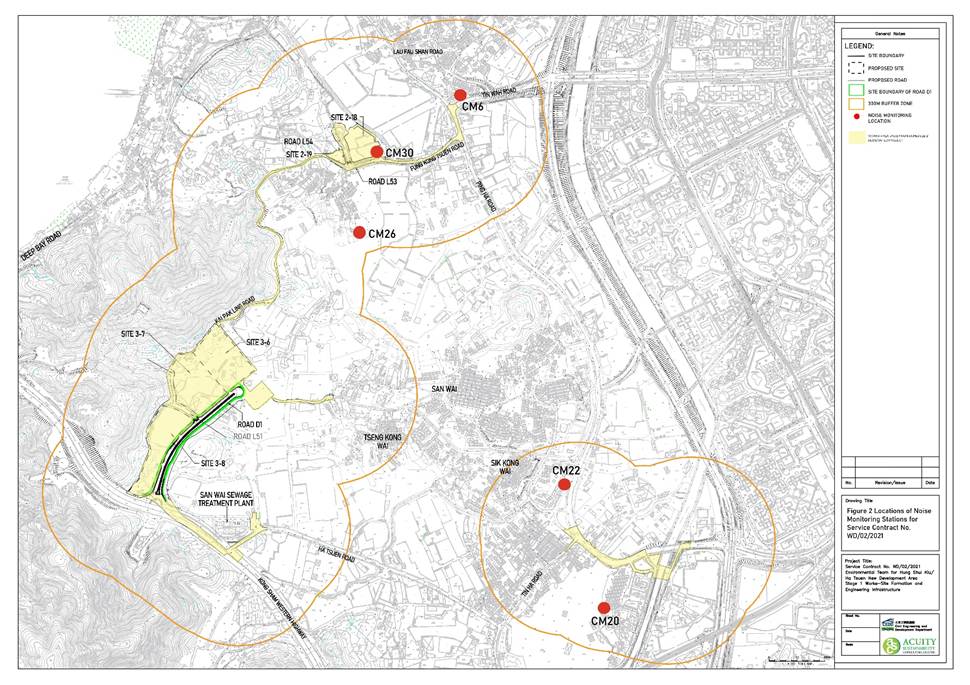

Figure 3.1 Construction Noise Monitoring Locations for Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

A map of a city

AI-generated content may be incorrect.

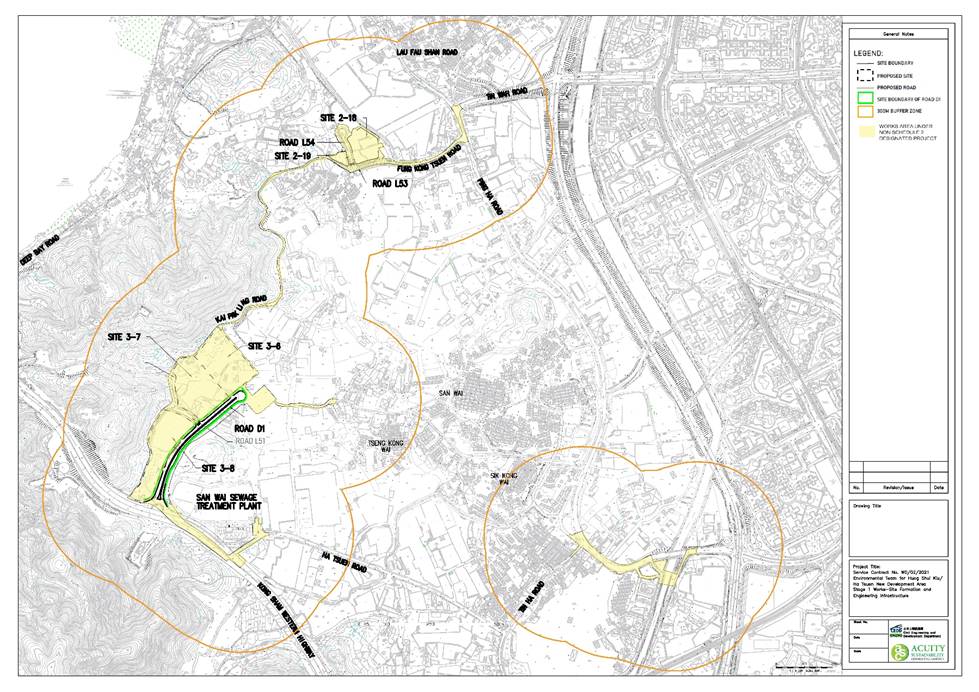

Figure 3.2 Construction Noise Monitoring Locations for Non-Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

3.4           Monitoring Equipment 3.4.1        Sound level meters and calibrators shall comply with the International Electrotechnical Commission Publication 651:1979 (Type 1) and 804:1985 (Type 1) specification as referred to in the Technical Memorandum (TM) issued under the Noise Control Ordinance.  The sound level meters shall be supplied and used with the manufacturer recommended weather shield as appropriate. 3.4.2        Sound level meters shall be calibrated using a portable calibrator prior to and following each noise measurement.  The calibration levels shall be noted with the measurement results and where the difference between the calibration levels is greater than 1.0 dB(A), the measurement shall be repeated.  3.4.3        Noise measurements will not be made in the presence of fog, rain, wind with a steady speed exceeding 5 m/s or wind with gusts exceeding 10 m/s. 3.5           Monitoring Methodology 3.5.1        The details of noise measurement procedures are described as follows:

§   Free-field and façade measurements were made at the monitoring locations.

§   For free field, the sound level meter was set at a height of 1.2 m above ground.

§   For façade measurement, the microphone of the sound level meter was positioned 1 m away from the building external wall of sensitive receiver, and the sound level meter was set up at a height of 1.2 m above ground.

§   Regular visits, for a period of at least once every three to four days, were conducted by the ET to ensure the continuous operation of the sound level meter during the baseline monitoring.  The battery condition was checked to ensure proper functioning of the meter.

§   A-weighted Leq, L10 and L90 were measured by weatherproof logging sound level meter over a two-week period, and a sampling period of 5 minutes was used throughout the baseline monitoring.

§   Parameters such as frequency weighting, the time weighting and the measurement time were set as follows:

·           Frequency weighting:             A

·           Time weighting:                     Fast

·           Measurement time:                 Six consecutive Leq (5-min) readings are measured to

    provide Leq (30-min) for the non-restricted hours.

§   Prior to and after each noise measurement, the meter was calibrated using an acoustic calibrator for 94.0 dB at 1000 Hz.  If the difference in the calibration level before and after measurement was more than 1.0 dB, the measurement would be considered invalid and repeat of noise measurement would be required after recalibration or repair of the equipment.

§   No construction activities were observed near the monitoring stations during the baseline monitoring.  Measurements were recorded to the nearest 0.1 dB.

§   Noise measurement should be paused during periods of high intrusive noise if possible and observation shall be recorded when intrusive noise is not avoided.

§   Noise monitoring should be conducted with the wind speed not exceeding 5 m/s and no gusts exceeding 10 m/s.

3.6           Maintenance and Calibration

1

2

3

3.1

3.2

3.3

3.4

3.5

3.6

3.6.1        Maintenance and calibration procedures are as follows:

·        The microphone head of the sound level meter and calibrator were regularly cleaned with a soft cloth; and

·        The sound level meter and acoustic calibrator were calibrated annually by a HOKLAS accredited laboratory or the manufacturer.

3.7           Results and Observations 3.7.1        The baseline noise monitoring at CM6 had been conducted under the project of Road Widening Works at Tin Wah Road and the monitoring results were presented in the corresponding Baseline Monitoring Report([5]). The baseline noise monitoring at CM6 had been verified by the IEC of project of Road Widening Works at Tin Wah Road. 3.7.2        The baseline noise monitoring at CM20, CM22, CM26 and CM30 had been conducted under HSK/HT NDA Second Phase Development and the monitoring results were presented in the corresponding Baseline Monitoring Report([6]).  The baseline noise monitoring at CM20, CM22, CM26 and CM30 had been verified by the IEC of HSK/HT NDA Second Phase Development. 3.7.3        The verified baseline monitoring results are summarized in Tables 3.3 to 3.5. Table 3.3     Summary of Noise Monitoring Results during 07:00 – 19:00
Noise Monitoring Station Average Leq(30-min) Minimum Leq(30-min) Maximum Leq(30-min)
Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road
CM6 72.7 66.5 76.1
CM26 * 47.6 38.1 64.7
CM30 * 60.2 38.5 72.5
Sha Chau Lei Tsuen
CM20 * 57.8 50.8 71.8
CM22 * 63.9 50.6 80.8
Note: *     For free field measurement, +3 dB(A) was added to the measured results. Reference: 1.       Quotation No. PU 01/2024: Environmental Team For Road Widening Works At Tin Wah Road, “Baseline Monitoring Report”, June 2025. (https://www.tinwahroadwidening.lamenviro.com/web/report/EPS/BMR/Baseline%20Monitoring%20Report_final(2025.06).pdf) 2.       Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024. (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176)   Table 3.4     Summary of Noise Monitoring Results during 19:00 – 23:00
Noise Monitoring Station Average Leq(30-min) Minimum Leq(30-min) Maximum Leq(30-min)
Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road
CM26 * 47.5 38.5 54.8
CM30 * 57.1 38.7 71.7
Sha Chau Lei Tsuen
CM20 * 55.6 48.0 66.9
CM22 * 58.4 47.9 68.3
Note: *     For free field measurement, +3 dB(A) was added to the measured results. Reference: Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024. (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176)   Table 3.5     Summary of Noise Monitoring Results during 23:00 – 07:00 of the following day
Noise Monitoring Station Average Leq(30-min) Minimum Leq(30-min) Maximum Leq(30-min)
Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road
CM26 * 46.4 39.2 55.8
CM30 * 51.2 38.5 67.6
Sha Chau Lei Tsuen
CM20 * 54.6 48.3 70.1
CM22 * 56.4 44.6 78.8
Note: *     For free field measurement, +3 dB(A) was added to the measured results. Reference: Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024. (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176)   3.8           Action and Limit Level 3.8.1        The criteria for action and limit levels for construction noise are defined in Table 3.6.

Table 3.6     Action and Limit Levels for Construction Noise Monitoring

Time Period

Action

Limit

07:00 - 19:00 on normal weekdays

When one or more documented complaints are received

75 dB(A)

4                WATER QUALITY 4.1           Monitoring Requirements 4.1.1        In accordance with the recommendations of the EIA Report (EIAO Register No. AEIAR-203/2016) and the Updated EM&A Manual (April 2022), the baseline water quality monitoring was conducted to establish baseline conditions to derive the Action and Limit levels for impact stations. 4.2           Water Quality Parameters and Monitoring Frequency 4.2.1        The parameters that have been selected for measurement in-situ and in the laboratory are those that are either determined in the EIA to be those with the most potential to be affected by the construction works or a standard check on water quality conditions. Parameters to be measured in the baseline water quality monitoring are listed in Table 4.1.

 Table 4.1    Parameters measured in the Baseline Water Quality Monitoring

Parameters

Units

Abbreviations

Frequency

In-situ measurements

3 days per week for at least 4 weeks (the interval between 2 sets of monitoring should not be less than 36 hours)

Dissolved oxygen

mg/L

DO

Dissolved oxygen saturation

%

DO%

Temperature

-

pH

-

-

Turbidity

NTU

-

Laboratory measurements

Suspended Solids

mg/L

SS

4.2.2        In addition to the water quality parameters, other relevant data were also being measured and recorded in data record sheet, including the location of the sampling stations, time, weather conditions, special phenomena and work activities undertaken around the monitoring stations and works area that may influence the monitoring results. 4.3           Monitoring Locations 4.3.1        In accordance with the Updated EM&A Manual([7]), the baseline water quality monitoring stations for Schedule 2 Designated Project (DP) are presented in Figure 4.1. The baseline water quality monitoring stations for non-Schedule 2 Designated Project (DP) are shown in Figure 4.2 and detailed in Table 4.2.

Figure 4.1 Locations of Water Quality Monitoring Stations for Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Figure 4.2 Locations of Water Quality Monitoring Stations for Non-Schedule 2 Designated Project (DP) under HSK/HT NDA Stage 1 Works

Table 4.2     Water Quality Monitoring Stations for Non-Schedule 2 DP under HSK/ HT NDA Stage 1 Works

Station

Description

Easting

Northing

Site 2-18, Site 2-19, Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road

LFS

Gradient station

(Downstream of the construction site of Site 2-18 and 2-19)

816504

835862

D1

Impact Station

(Downstream of LFS and the construction site of Site 2-18 and 2-19)

816187

836064

D2a

Impact Station

(Downstream of the construction site at Fung Kong Tsuen Road, Ha Tsuen Road/ Lau Fau Shan Road)

817483

835855

Road L51

U1

Upstream Station

815936

834150

SW

Gradient station

(Downstream of U1 and the construction site of Road L51)

816304

834321

HT

Gradient station

(Downstream of the construction site of Road L51)

816866

834314

TKW1

Gradient station

(Downstream of the construction site of Road L51)

816563

834686

TKW

Gradient station

(Downstream of TKW1 and construction site of Road L51)

816594

834690

LUTa

Gradient station

(Downstream of the construction site of Road L51)

817547

834717

D2a

Impact Station

(Downstream of LUTa and the construction site of Road L51)

817483

835855

Sha Chau Lei Tsuen

TSR1a

Gradient station

(Upstream of the construction site at Sha Chau Lei Tsuen)

817786

834125

LUTa

Gradient station

(Downstream of the construction site at Sha Chau Lei Tsuen)

817547

834717

D2a

Impact Station

(Downstream of TSR1a and LUTa, and the construction site of Sha Chau Lei Tsuen)

817483

835855

Reference: Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Updated EM&A Manual”, April 2022. 4.4           Monitoring Equipment and Methodology 4.4.1        In-situ measurements at monitoring locations including DO, DO%, pH, temperature and turbidity were collected using equipment such as water sampler and multi parameter water quality system. The detection limit for the in-situ measurement is shown in Table 4.3. 4.4.2        Water samples for suspended solids (SS) analysis were stored in high density polythene bottles, packed in ice (cooled to 4 ºC without being frozen), and delivered to a HOKLAS laboratory as soon as possible after collection of the water samples.

Table 4.3     Detection Limits and Precision for Water Quality Determinates

Parameters

Detection limit

Accuracy

Precision

DO

0 – 20 mg/L

± 0.1 mg/L

25%

Temperature

0 – 45 oC

± 0.1 oC

pH

0 – 14

± 0.1

Turbidity

0 – 1000 NTU

± 2

4.4.3        During the baseline monitoring, the depths of waters at the monitoring stations were all less than 3 m.  Thus, only mid-depth samples were collected.  For in-situ measurements, duplicate readings were made at each station.  Duplicate water samples were also collected at each station. 4.4.4        In-situ monitoring instruments for water quality parameters were checked, calibrated and certified by a laboratory accredited under HOKLAS before use.  Responses of sensors and electrodes were checked with certified standard solutions before each use.  Wet bulb calibration for a DO meter was carried out before measurement at each monitoring day. 4.5           Laboratory Measurement and Analysis 4.5.1        Analysis of SS was carried out in a HOKLAS accredited laboratory, Acumen Laboratory and Testing Limited (Reg. No. HOKLAS 241).  Sufficient water samples were collected at each of the monitoring stations for carrying out the laboratory SS determination. 4.5.2        The SS determination works started within 24 hours after collection of the water samples.  The analysis followed the APHA 2540D analytical method with the detection limit of 1.0 mg/L. 4.5.3        Parameters for laboratory measurements, their standard methods and the detection limits are presented in Table 4.4.

Table 4.4     Analytical Methods Applied to Water Quality Samples

Parameter

Standard Method

Detection Limit

Accuracy

Suspended Solids (mg/L)

APHA 2540D

1.0 mg/L

±17%

4.6           QA/QC Requirements

Decontamination Procedures

4.2

4.6.1        Water sampling equipment used during the course of the monitoring process was decontaminated by manual washing and rinsed with distilled water after each sampling event. All of the disposable components/ accessories were discarded after sampling.

Sampling Management and Supervision

4.6.2        All sampling bottles were labelled with the sample ID numbers (including the sampling station), and sampling date.  Water samples were dispatched to the testing laboratory for analysis as soon as possible.  All the collected samples were stored in a cool box to keep the temperature less than 4 ℃ but without frozen.  All water samples were handled under chain of custody protocols and relinquished to the laboratory representatives at locations specified by the laboratory.

Quality Control Measures for Sample Testing

4.6.3        Quality control of laboratory analysis of water samples was performed by a HOKLAS accredited laboratory for every batch of 20 samples:

·      A minimum of 1 laboratory method blank was analyzed;

·      A minimum of 1 sample duplicate was analyzed; and

·      A minimum of 1 sample matrix spike was analyzed.

4.7           Results and Observations 4.7.1        Baseline water quality monitoring at U1, SW, HT, TKW and TKW1 were carried out under HSK/ HT NDA Stage 1 Works in 2022, while baseline monitoring at TSR1a, LUTa, LFS, D1 and D2a were carried out under HSK/HT NDA Second Phase Development in 2024.  The monitoring results are presented in the corresponding Baseline Monitoring Reports ([8], [9]).  Tables 4.5 and 4.6 summarize the baseline water quality monitoring results already verified under HSK/HT NDA Stage 1 Works.  Table 4.7 summarizes the baseline water quality monitoring results already verified under HSK/HT NDA Second Phase Development. Table 4.5     Summary of Baseline Water Quality Monitoring Results of U1, SW, HT, TKW and TKW1 (Wet Season)

Locations

Parameters

Temperature (°C)

pH

DO (mg/L)

(Middle)

Turbidity

(NTU)

SS (mg/L)

U1

Average

22.6

8.1

7.3

17.5

12.8

Minimum

19.9

7.3

4.3

4.7

3.7

Maximum

26.8

9.1

10.5

53.2

36.0

SW

Average

22.7

7.9

7.2

11.5

6.2

Minimum

20.2

7.4

3.5

1.9

<1.0

Maximum

26.4

8.6

10.7

23.2

24.0

HT

Average

22.6

8.0

6.9

16.2

15.4

Minimum

20.2

7.3

2.2

2.8

<1.0

Maximum

26.1

8.7

10.6

45.1

69.0

TKW1

Average

22.7

8.0

7.7

14.3

9.4

Minimum

20.3

7.4

2.8

3.4

<1.0

Maximum

26.4

8.7

10.8

63.2

54.0

TKW

Average

22.7

7.9

7.0

14.4

10.2

Minimum

20.2

7.4

2.4

4.0

<1.0

Maximum

26.3

8.7

10.3

57.3

52.0

Source: Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Baseline Monitoring Report (Environmental Permit No. EP-528/2017)”, August 2023. Table 4.6     Summary of Baseline Water Quality Monitoring Results of U1, SW, HT, TKW and TKW1 (Dry Season)

Locations

Parameters

Temperature (°C)

pH

DO (mg/L)

(Middle)

Turbidity

(NTU)

SS (mg/L)

U1

Average

15.0

7.7

5.8

10.1

11.4

Minimum

12.2

6.8

3.0

4.2

1.2

Maximum

18.0

8.7

7.6

21.0

98.0

SW

Average

15.5

7.5

3.6

10.4

4.9

Minimum

3.2

7.1

1.9

2.8

1.0

SW

Maximum

20.1

8.2

4.9

22.4

16.0

HT

Average

16.1

7.5

2.8

9.7

3.6

Minimum

11.8

7.2

2.1

1.2

1.0

Maximum

18.8

8.0

5.8

31.6

8.3

TKW1

Average

16.5

7.5

2.8

9.5

3.8

Minimum

12.0

7.0

2.0

2.5

1.0

Maximum

20.0

8.2

4.3

17.9

12.0

TKW

Average

16.4

7.4

2.9

12.0

3.9

Minimum

11.2

7.1

2.2

3.3

1.9

Maximum

19.9

8.1

4.2

26.8

7.6

Reference: Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Baseline Monitoring Report (Environmental Permit No. EP-528/2017)”, August 2023. Table 4.7     Summary of Baseline Water Quality Monitoring Results at TSR1a, LUTa, LFS, D1 and D2a

Locations

Parameters

Temperature (°C)

pH

DO (mg/L)

(Middle)

Turbidity

(NTU)

SS (mg/L)

TSR1a

Average

30.6

7.6

7.7

7.3

5.3

Minimum

25.8

6.9

4.4

1.3

1.8

Maximum

34.4

8.2

9.7

16.2

14.0

LUTa

Average

30.8

7.5

5.5

6.5

5.7

Minimum

25.7

7.2

0.2

2.9

1.3

Maximum

34.5

8.0

7.7

10.5

20.9

LFS

Average

28.4

7.3

3.9

15.2

7.9

Minimum

25.9

7.0

0.8

8.9

2.0

Maximum

30.3

7.6

6.1

30.8

25.0

D1

Average

28.9

7.2

5.1

17.2

13.6

Minimum

26.0

6.8

1.0

9.4

1.3

Maximum

31.5

7.4

7.4

43.7

52.4

D2a

Average

30.8

7.7

2.1

7.9

15.9

Minimum

24.7

7.3

0.5

3.8

1.8

Maximum

35.9

8.1

4.5

11.7

138.0

Reference: Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024. (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176) 4.8           Action and Limit Levels 4.8.1        The Action and Limit Levels were derived following the approach specified in the Updated EM&A Manual as shown in Table 4.8.

Table 4.8     Determination of Action and Limit Levels of Water Quality for Impact Monitoring

Parameters

Action

Limit

DO in mg/L

Surface and Middle, Bottom DO

≤5%-ile of baseline data

Surface and Middle DO

≤4 mg/L and 1%-ile of baseline data for surface and middle layers

Bottom DO

≤2 mg/L and 1%-ile of baseline data for bottom layer

SS in mg/L

Depth-averaged SS

·    ≥ 95%-ile of baseline data or

·    120% of upstream control station of the same day (applicable to station at SW and HT only)

Depth-averaged SS

·    ≥ 99%-ile of baseline data or

·    130% of upstream control station of the same day (applicable to station at SW and HT only)

Turbidity in NTU

Depth-averaged Turbidity

·    ≥ 95%-ile of baseline data or

·    120% of upstream control station of the same day (applicable to station at SW and HT only)

Depth-averaged Turbidity

·    ≥ 99%-ile of baseline data or

·    130% of upstream control station of the same day (applicable to station at SW and HT only

pH

Beyond the range 6.6 – 8.4

Beyond the range of 6.5 – 8.5

Note:

(1)    For DO, non-compliance of the water quality limit occurs when monitoring result is lower than the limit.

(2)    For SS and turbidity, non-compliance of the water quality limit occurs when monitoring result is higher than the limit.

4.8.2        Based on the baseline water quality monitoring data and the approach specified in Table 4.8, the Action and Limit Levels were derived and are presented in Tables 4.9 to 4.11.

Table 4.11   Action and Limit Levels for Impact Water Quality Monitoring at D2a and D1

Parameters

Action Levels *

Limit Levels *

D2a

DO (mg/L)

5.4

4

Turbidity (NTU)

11.6

11.7

SS (mg/L)

14.0

15.6

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

D1

DO (mg/L)

4.2

4

Turbidity (NTU)

23.4

24.5

SS (mg/L)

32.8

36.8

pH

Less than 6.6 or greater than 8.4

Less than 6.5 or greater than 8.5

Note:

*     Action and Limit Levels are extracted from the Baseline Monitoring Report (December 2024) prepared for Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team.

       (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176).

5                COMMENTS AND CONCLUSION 5.1           Revision for Inclusion in the EM&A Manual 5.1.1        The baseline monitoring was conducted according to the Updated EM&A Manual for air quality, noise and water quality. 5.1.2        The monitoring methodology, parameters monitored, and monitoring locations are all generally in line with the Updated EM&A Manual. 5.2           Air Quality 5.2.1        According to the layout of HSK/HT NDA Stage 1 Works, 14 air quality monitoring stations were identified for the EM&A programme of non-Schedule 2 DP. 5.2.2        Baseline air quality monitoring at AM18, AM19 and AM20 was conducted from 6 August 2025 to 19 August 2025.  The baseline air quality monitoring of AM7, AM8a, AM9, AM11, AM12, AM13, AM15 and AM21 had been carried out and the results were verified by the IEC of HSK/HT NDA Second Phase Development earlier. The baseline air quality monitoring of AM23, AM24 and AM25a had been carried out and the results were verified by the IEC of HSK/HT NDA Stage 1 Works earlier. 5.2.3        Action and Limit Levels for non-Schedule 2 DP under HSK/HT NDA Stage 1 Works were derived according to the Updated EM&A Manual. 5.3           Construction Noise 5.3.1        According to the layout of HSK/HT NDA Stage 1 Works, 5 noise monitoring stations were identified for the EM&A programme of non-Schedule 2 DP. 5.3.2        Baseline noise monitoring at CM6 had been carried out and the results were verified by the IEC of the project of Road Widening Works at Tin Wah Road earlier. 5.3.3        Baseline noise monitoring at CM20, CM22, CM26 and CM30 had been carried out and the results were verified by the IEC of HSK/HT NDA Second Phase Development earlier. 5.3.4        Action and Limit Levels for non-Schedule 2 DP under HSK/HT NDA Stage 1 Works were derived according to the Updated EM&A Manual. 5.4           Water Quality 5.4.1        According to the layout of HSK/HT NDA Stage 1 Works, 10 water quality monitoring stations were identified for the EM&A programme of non-Schedule 2 DP. 5.4.2        Baseline water quality monitoring at U1, SW, HT, TKW and TKW1 had been carried out and the results were verified by the IEC of HSK/HT NDA Stage 1 Works earlier. Baseline water quality monitoring at TSR1a, LUTa, LFS, D1 and D2a had been carried out and the results were verified by the IEC of HSK/HT NDA Second Phase Development earlier. 5.4.3        Action and Limit Levels for non-Schedule 2 DP under HSK/HT NDA Stage 1 Works were derived according to the Updated EM&A Manual. 5.5           Comment/ Recommendation 5.5.1        No further comment or recommendation was provided in this baseline monitoring report.

([1])      Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Baseline Monitoring Report (Environmental Permit No. EP-528/2017)”, August 2023.

           (https://hskhtnda-s1.com/upload/HSK%20Baseline%20Monitoring%20Report_R5_signed.pdf?v=1673843881)

([2])     Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Updated EM&A Manual”, April 2022.

([3])     Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Updated EM&A Manual”, April 2022.

([4])     Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Updated EM&A Manual”, April 2022.

([5])     Quotation No. PU 01/2024: Environmental Team For Road Widening Works At Tin Wah Road, “Baseline Monitoring Report”, June 2025. (https://www.tinwahroadwidening.lamenviro.com/web/report/EPS/BMR/Baseline%20Monitoring%20Report_final(2025.06).pdf)

([6])     Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024. (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176)

([7])     Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Updated EM&A Manual”, April 2022.

([8])     Service Contract No. WD/02/2021, Environmental Team for Hung Shui Kiu/Ha Tsuen New Development Area Stage 1 Works – Site Formation and Engineering Infrastructure, “Baseline Monitoring Report (Environmental Permit No. EP-528/2017)”, August 2023.

([9])     Service Contract No. WD/03/2023, Hung Shui Kiu/Ha Tsuen New Development Area Second Phase Development – Environmental Team, “Baseline Monitoring Report”, December 2024.           (https://hskhtnda-p2.com/upload/HSK%20NDA%20Second%20Phase_BMR_R2(full).pdf?v=1739355176)
